Culver City Driveway Permit: What It Took on a Real Job

6 min read
Share:

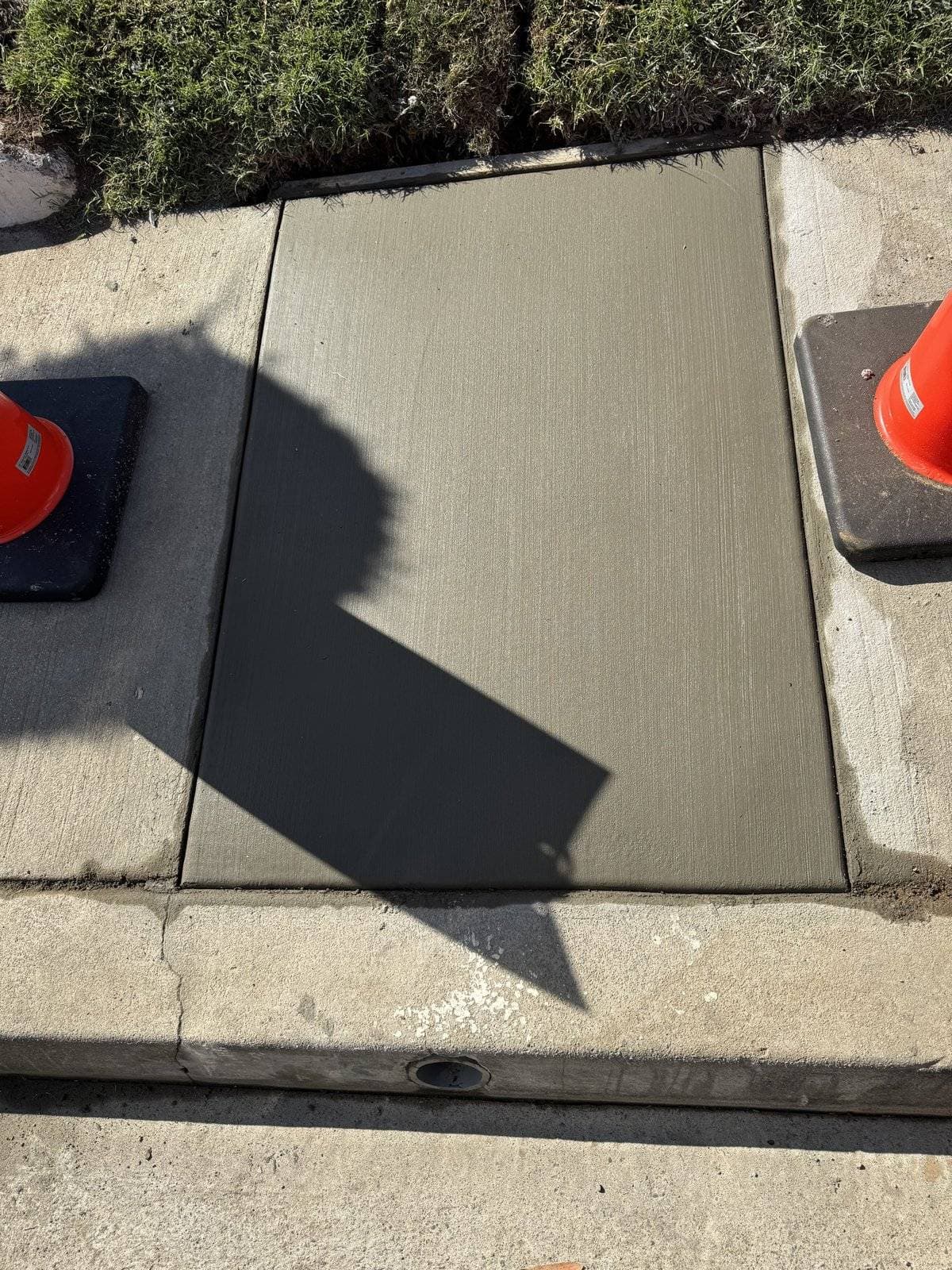

New concrete sidewalk panel at the curb above a drain outlet in Culver City
On this page
  1. 1. The Driveway and Drainage Scope
  2. 2. Do You Need a Permit to Replace a Driveway in Culver City?
  3. 3. What the Permit Cost
  4. 4. How Long the Permit Took
  5. 5. What the Approved Plans Included
  6. 6. The Dumpster: City Bins Only
  7. 7. Five Days on Site
  8. 8. After Your New Driveway
  9. 9. Frequently Asked Questions
  10. Local Tip: Planning a Driveway Permit in Culver City
  11. Local Tip: Dumpster Logistics in Culver City

A driveway replacement in Culver City goes through the city before any concrete is poured. On one of our Culver City driveway and drainage jobs, Site Improvement permit review took about four months, and the city permit fees came to about $1,550. The approved plans set the driveway at 16 feet and tied the new drain into the existing curb drain, and the debris went into a city roll-off.

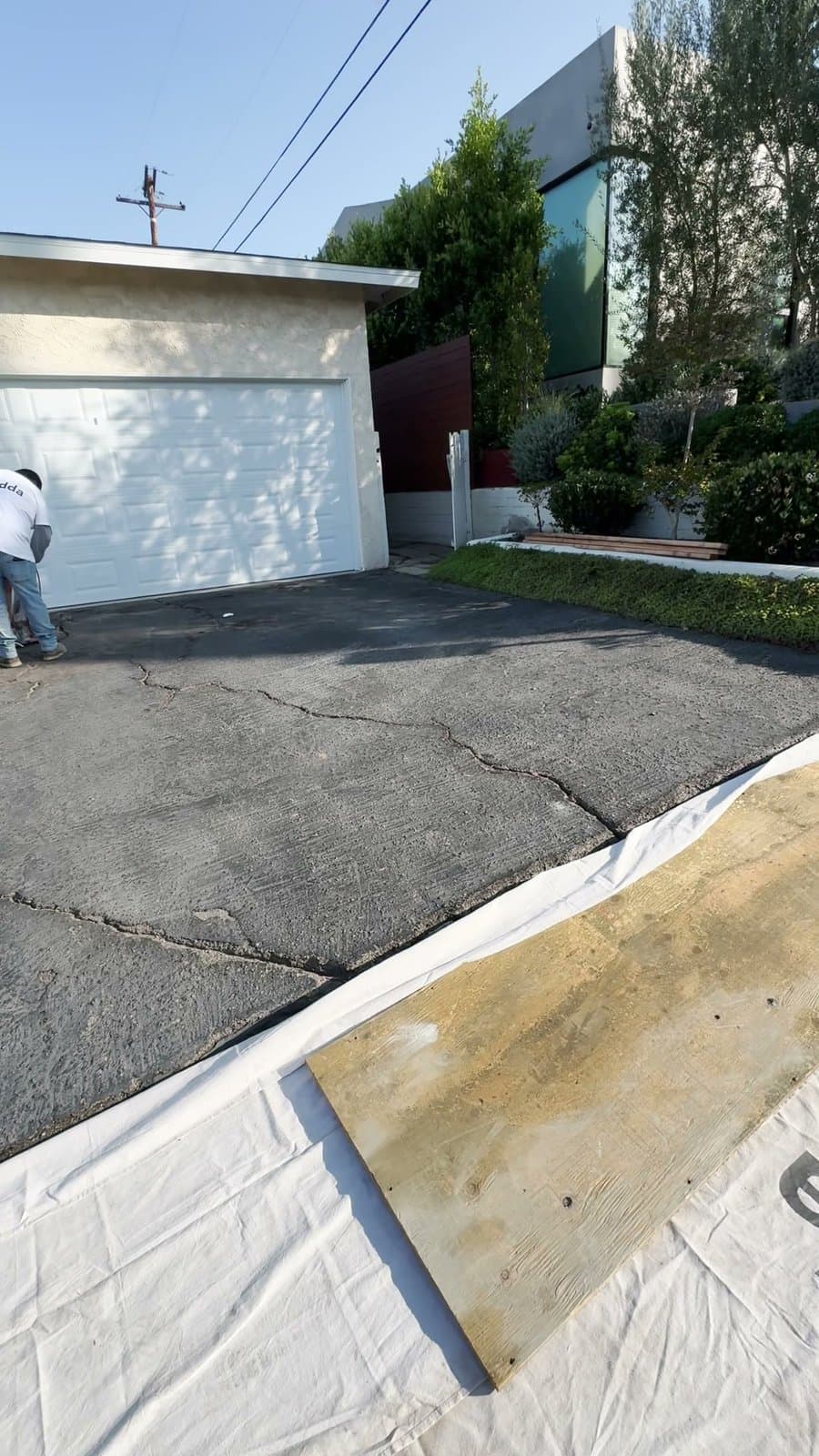

Cracked old asphalt driveway in Culver City before Buildda replaced it with concrete
Day one: the old asphalt driveway before demolition.

1. The Driveway and Drainage Scope

The homeowners wanted the old asphalt driveway gone and a concrete walkway along the side of the house replaced, with a drain that would move water off the property. We submitted the plans for city review before construction. The approved plans specified a 16-foot-wide driveway and a connection to the existing curb drain.

Connecting the drain to the street meant cutting and re-pouring a section of the public sidewalk, about 5 by 5 feet. Before any work started, a city inspector came out for a pre-construction inspection.

On site, the job took five days in all. Day one was demolition: the asphalt driveway and the concrete side walkway came out. Day two was the drain line and the sidewalk cut. Day three was the pour. The city completed its inspections and finaled the permit.

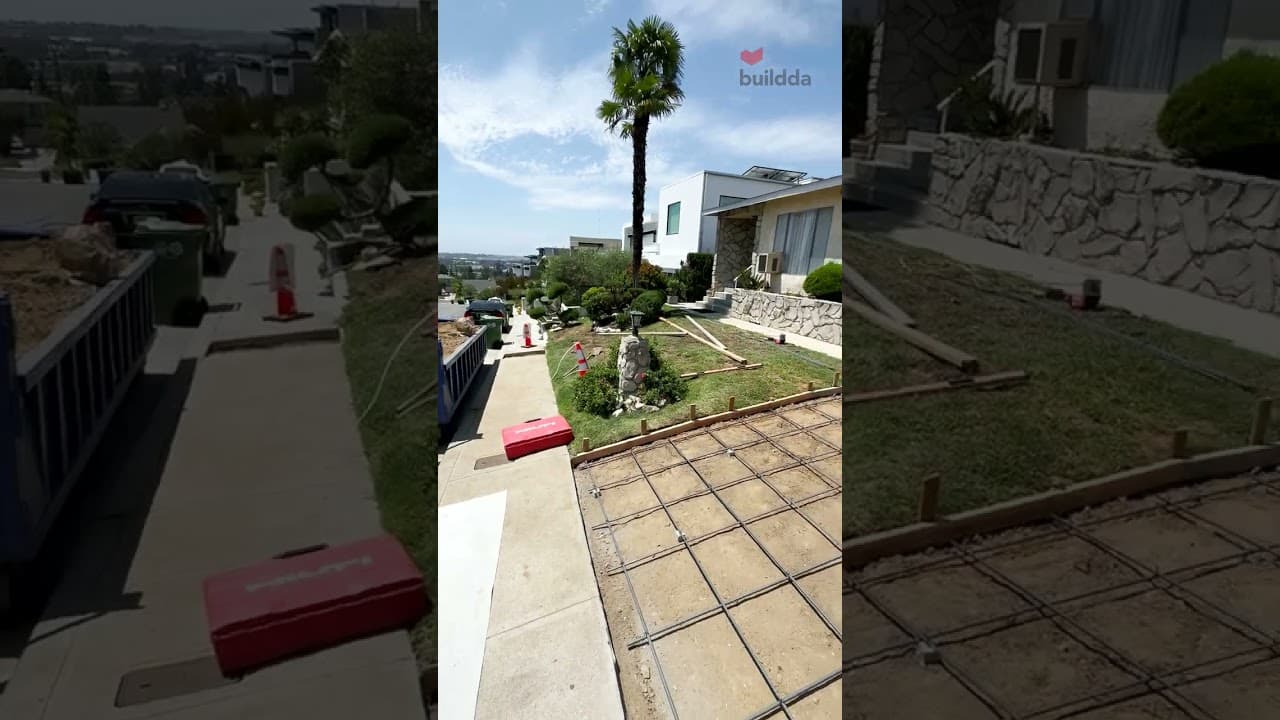

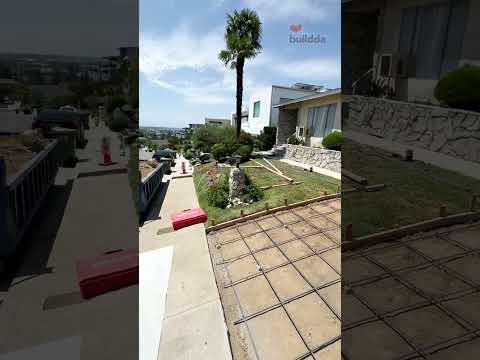

The whole driveway in 17 seconds: old asphalt out, sidewalk cut for the drain, pour, broom pass.

2. Do You Need a Permit to Replace a Driveway in Culver City?

For this job, yes. Culver City Public Works, through the Engineering Division, reviewed the on-site driveway pavement and drainage under a Site Improvement permit, rather than a building permit. Confirm which permits your own scope needs, including any work in the public sidewalk or street.

A Site Improvement permit in Culver City is valid for 180 days from issuance. The city can extend it once, at the City Engineer's discretion, with an extension fee. Plan the work inside that window, because the clock starts at issuance, not at the first day of work, and confirm your permit's deadlines with the Engineering Division before scheduling construction.

Buildda Tip

Apply before you pick a start date. On this job, permit review took about four months. Allow for plan review and corrections before committing to a construction start date.

3. What the Permit Cost

The Site Improvement permit fees on this job came to about $1,550, paid in full at issuance. That is the city's permit fee only. The dumpster and the debris are billed separately (section 6).

The city charges on this project:

Charge on this projectAmount
Site Improvement permit feesabout $1,550
City roll-off for 9.92 tons of old asphalt and concreteabout $1,800

The rates listed on the street permit form used for this project:

Street permit itemRate listed on the form
Dumpster street permit, outside downtown$8 per parking space per day, plus an issuance fee and a 4 percent technology surcharge
No-parking signs for the dumpster$4.25 each, two minimum

These are this project's city charges and the rates on the form used for it, not a quote. Confirm current fees with the city. For what the concrete work itself can run, see our concrete driveway cost page.

4. How Long the Permit Took

Permit review on this project took about four months.

5. What the Approved Plans Included

The approved plans specified the driveway width and the drainage connection described below.

Driveway width

The approved plans specified a 16-foot-wide driveway.

Drain to the curb

The approved drainage plan connected the new drain to the existing curb drain.

The sidewalk cut

To reach the curb drain, the pipe had to cross under the public sidewalk. That meant cutting and re-pouring a section of the public sidewalk about 5 by 5 feet, done together with the driveway work.

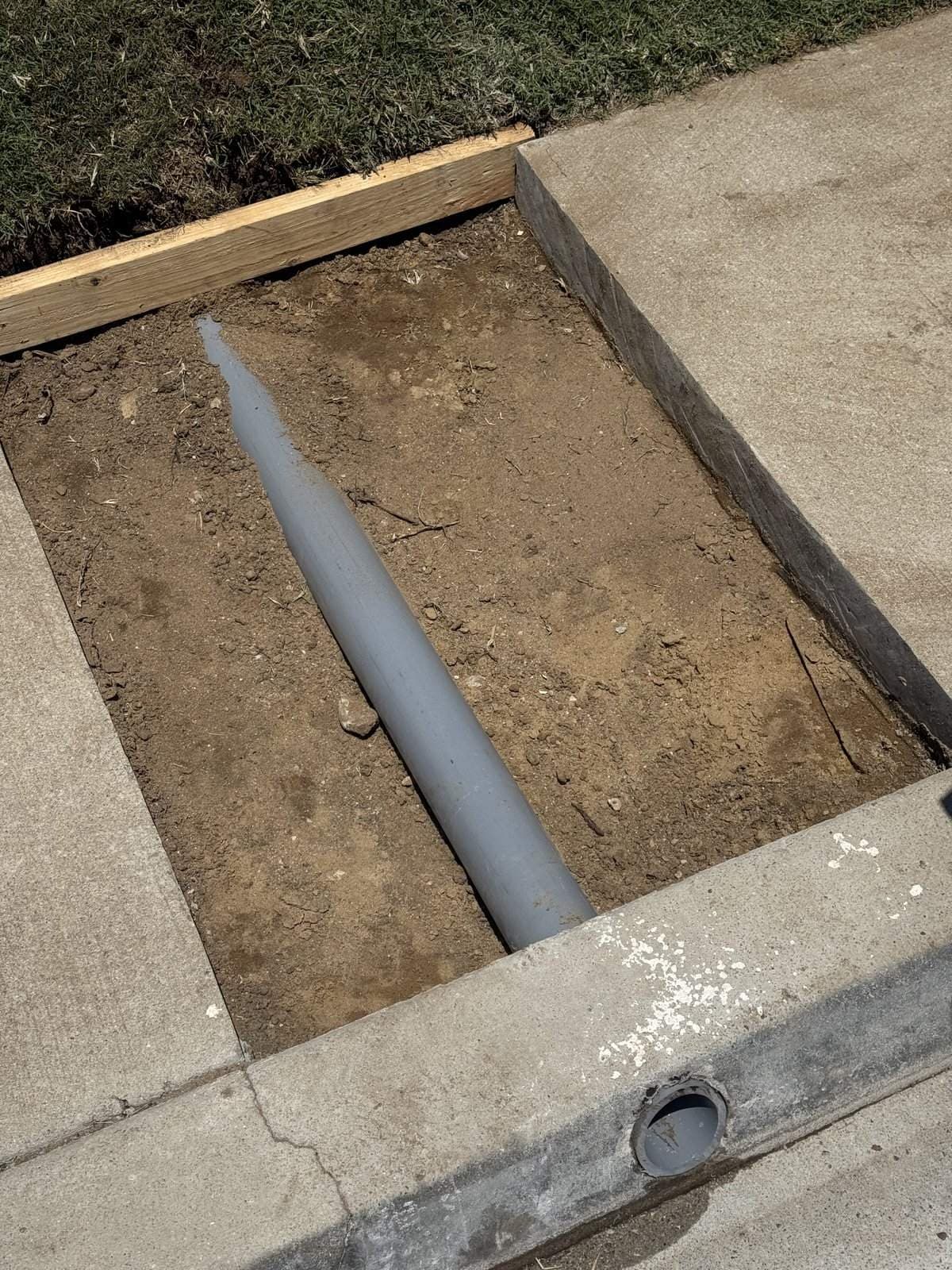

Gray drain pipe running through a cut section of sidewalk to the curb in Culver City
The drain line crossing under the cut sidewalk to the curb.

6. The Dumpster: City Bins Only

In Culver City, trash and construction debris hauling is handled only by the city (Culver City Municipal Code 5.01.010). A private dumpster company cannot place a bin. We ordered the roll-off through Culver City Sanitation, and because the bin sat on the street, it also needed a separate dumpster street permit.

The street permit form used for this project listed $8 per parking space per day outside downtown, $4.25 per no-parking sign with a two-sign minimum, an issuance fee and a 4 percent technology surcharge. Signs required posting at least 48 hours ahead. Confirm the current fees and posting requirements with the city when you arrange your project.

The roll-off is billed mostly by the ton. On this job the old asphalt and concrete weighed 9.92 tons, and the city's roll-off bill came to about $1,800, including the tonnage, emptying the bin and the rental. Debris weight, rental time and the city's charges set the roll-off cost, so a bigger driveway usually means a bigger bill.

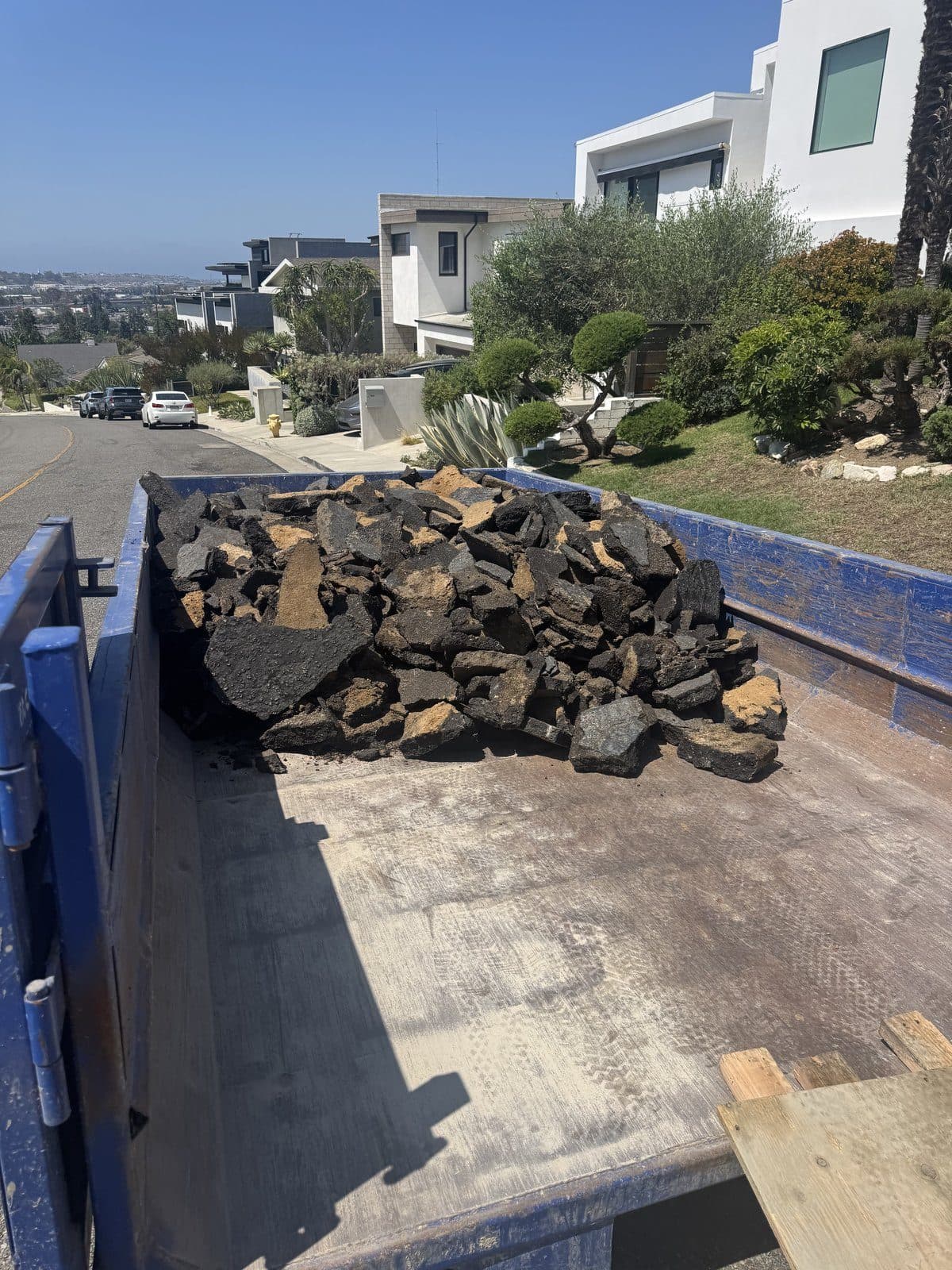

Broken asphalt loaded into a blue Culver City roll-off bin on the street
Old asphalt in the city roll-off.

Buildda Tip

The city dumpster takes concrete and asphalt broken into pieces about 2 feet by 2 feet or smaller. Break the old driveway small as you go. Confirm how the city will deliver the roll-off invoice, watch for it after the bin is picked up, and pay by the stated due date.

7. Five Days on Site

Day one: demolition. The asphalt driveway and the side walkway came out and went into the city roll-off.

Day two: the drain line went in and the sidewalk was cut.

Day three: the pour.

The remaining days finished the job.

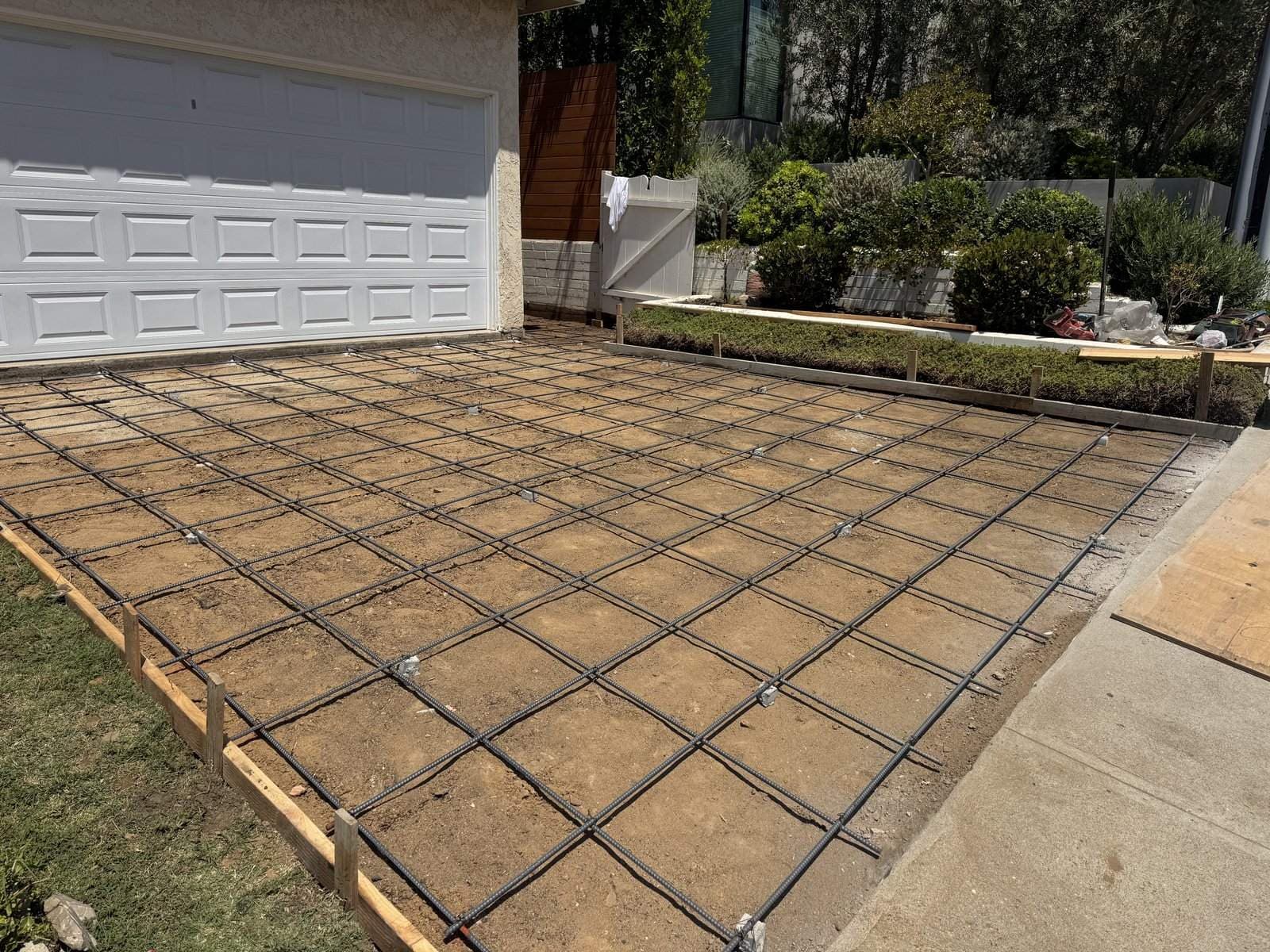

Steel grid set on the prepared driveway base before the concrete pour
The prepared base with the steel grid set before the pour.

The city completed its inspections and finaled the permit.

8. After Your New Driveway

The first days matter most. Early curing helps concrete develop its strength and durability, and in LA heat and wind the risk is the surface drying out too fast. Follow your installer's instructions for curing, including how long to keep covers in place or keep the slab moist, and avoid wetting and drying it on and off.

Passenger cars can often go on a new driveway after about 7 days, depending on the mix, the weather and the curing. Heavy vehicles such as a moving truck, an RV or a dumpster need longer, often about 30 days. Before any of them goes on the driveway, confirm with your installer that the slab was built for that load and has cured enough. Sealers are usually applied after about 30 days as well.

Control joints (the cut lines) help manage where shrinkage cracks form, but cracks can also appear elsewhere. Some fine cracks are cosmetic. A crack that widens, an uneven surface or a change in how water drains is worth having checked. Wipe up oil spills quickly.

9. Frequently Asked Questions

How much does a driveway permit cost in Culver City?

The Site Improvement permit fees on this project, one of our Culver City driveway and drainage jobs, were about $1,550. That covered the city permit only. The dumpster street permit and the city roll-off were billed separately, and on this project the city's roll-off bill came to about $1,800 for 9.92 tons of old asphalt and concrete.

How long does a Culver City driveway permit take?

Permit review on this project took about four months. Review times vary by project. Once the permit is issued it is valid for 180 days, so plan the work inside that window. The city can extend it once, with an extension fee.

Can I use my own dumpster company in Culver City?

No. Culver City handles trash and construction debris hauling itself, so the roll-off has to be ordered through Culver City Sanitation. If the bin sits on the street, it also needs a dumpster street permit. On this project, the street permit form listed per-space daily fees and called for no-parking signs posted at least 48 hours ahead.

Does Culver City require a drain for a new driveway?

On our job, the approved drainage plan connected the new drain to the existing curb drain. Reaching the curb meant cutting and re-pouring a section of the public sidewalk. Whether your driveway needs a drain depends on your site and the city's review of your plans.

How long before I can drive on a new concrete driveway?

Passenger cars can often go on a new driveway after about 7 days, depending on the mix, the weather and the curing. A moving truck, an RV or a dumpster needs longer, often about 30 days. Before any of them goes on the driveway, confirm with your installer that the slab was built for that load, and keep heavy wheels off the edges.

Local Tip: Planning a Driveway Permit in Culver City

Plan around the permit, not the calendar. Still choosing the surface? Our guide to driveway materials compares the options, and our page of driveway questions covers the common ones. Apply early and allow time for plan review: on this project, review took about four months. Once the permit is issued, the 180-day window starts, so check it before booking the crew.

Local Tip: Dumpster Logistics in Culver City

Only the city can place a roll-off in Culver City, so order it through Culver City Sanitation. A bin on the street also needs a dumpster street permit. Post the no-parking signs at least 48 hours before the bin arrives, and break the old concrete and asphalt into pieces about 2 feet by 2 feet or smaller so the city bin takes it.

Next Step

Planning a driveway or drainage project in Culver City? Text us about it, and add a photo if you have one.

Found this helpful? Share it with others.

Share:

Driveway work in your area

Professional contractors serving the Greater Los Angeles area

Also explore related services:

Ready to Start Your Project?

Get your no-obligation quote in just a few minutes. Our team typically responds within 24 business hours.

Text us about
your project
WhatsApp
